How to Manage Interior Design Projects: A Practical Guide for Indian Firms

A battle-tested 5-stage framework for Indian interior design firms to manage site surveys, itemised BOQs, drawing versions, 3-way vendor matching, and recorded client approvals.

DecorFlow Editorial TeamยทยทUpdated ยท15 min read
Summarise with AI:
The 5-stage interior project operating system for Indian firms: survey, BOQ, drawing control, procurement, and client portal

Managing an interior design project in India is rarely about aesthetic vision alone. Between civil sub-contractors knocking down partition walls, modular factory dispatch delays, society permissions for service lifts, and midnight WhatsApp messages from anxious homeowners, most studio principals spend their days firefighting on site instead of designing.

In our discussions with Indian interior studios, turnkey contractors, and modular design firms, projects almost never fail on the drawing board. They lose money and schedule through operational fragmentation: beam drops discovered only after factory-made carcasses arrive at the flat, carpenters fabricating to an outdated drawing revision, verbal change requests that turn into unbillable disputes at handover, and vendor invoices paid without physical site verification.

As we examined in our operational guides to avoiding interior project delays and stopping cost overruns, profitability requires an integrated workflow. This guide outlines a practical 5-stage interior project management framework built specifically for Indian residential and turnkey commercial fit-outs.

Diagram of the 5-stage interior project operating system showing survey, BOQ, drawing control, procurement, and client portal
The 5-stage project operating system that keeps Indian interior fit-outs on schedule and protects project margins.

Where Indian Interior Projects Bleed Margin

Before putting new systems in place, it helps to understand why interior projects in Indian cities struggle with margins. When a project wraps up and an expected 25% gross margin turns out to be 6%, the leakage usually traces back to three operational traps.

1. The WhatsApp and scrap-paper trap

Project discussions happen across five disjointed WhatsApp groups. Supervisors photograph tile progress on personal phones, BOQs live in offline spreadsheets on a designer's laptop, and invoices sit in desktop accounting software. When a client questions an extra electrical point four months later, retrieving an agreed message or marked-up drawing sheet takes hours of searching through chat histories.

2. Unpriced verbal scope creep

During weekend site visits, homeowners frequently make casual requests: adding cove lighting in the passage, extending a wardrobe loft, or shifting a switchboard. Supervisors often accommodate these requests on site to maintain goodwill. Without a formal change order that calculates material, labour, and timeline impact before work begins, the studio absorbs the extra cost.

3. Disconnected site measurements

When initial site surveys record wall lengths without noting beam drops, out-of-plumb walls, or uneven floor screeds, factory-cut modular carcasses clash on delivery. Cutting, refacing, or modifying carcasses on site wastes expensive materials, delays other trades, and leads to compromises in the final finish.

PillarFragmented studio approachSystematized operating approach
Site surveyDimensions scribbled on rough paper; beam drops and service lines omitted.Digital room perimeter survey with ft-in keypad, photo obstacle log, and civil constraints.
Cost estimationLump-sum room quotes ('Master Bedroom: โ‚น2.2L') hiding specifications.Itemised BOQ with material-versus-labour splits, named hardware, and explicit GST.
Drawing controlDrawings shared across WhatsApp; carpenters working from outdated prints.Single cloud repository with versioned revisions (Rev 0 to Rev 3) viewable on mobile.
ProcurementVerbal orders and cash slips; vendor bills paid without site delivery verification.Formal POs tied to BOQ; mobile GRN delivery sign-off; 3-way matching before payment.
Client approvalsDecisions scattered in WhatsApp threads; verbal variations disputed at final billing.Phone OTP client portal with dated approval logs and change orders priced in rupees and days.

Stage 1: Pre-Design Site Survey and Civil Constraints Audit

Effective interior project management begins before 3D visualization or mood boards. It starts on site with a thorough civil audit. In Indian residential high-rises and builder floors, structural and MEP constraints dictate what can actually be built.

A complete site survey protocol captures four critical layers:

  1. Perimeter geometry and wall plumb: record wall lengths in continuous sequence (in feet and inches or millimetres). Check whether corner angles are square (90 degrees). An out-of-plumb corner can create unsightly 20mm gaps behind modular wardrobes.

  2. Soffit levels and beam drops: measure clear floor-to-ceiling heights as well as beam bottom levels. Note HVAC duct runs and fire sprinkler drops to avoid false ceiling framing clashes later.

  3. Electrical and plumbing infrastructure: record main Distribution Board (DB) location, connected load, and phase configuration (single-phase or three-phase). In bathrooms and kitchens, log plumbing inlet points, geyser power outlets, and drain trap invert levels.

  4. Apartment society logistical constraints: check service lift dimensions, stairwell turning radius, permitted working hours (typically 10:00 AM to 5:00 PM with strict no-noise policies on Sundays), gate pass protocols, and malba (debris) disposal rules.

Sample civil site survey checklist and obstacle log for an interior project
A civil obstacle log keeps beams, risers and service points visible to the whole team before drawings are issued.
  • Verify apartment service lift dimensions and society entry timing rules
  • Record clear floor-to-beam soffit heights and duct drops in every room
  • Verify single-phase versus three-phase supply at the main electrical DB
  • Photograph wall dampness, hollow screed patches, and window sill leaks
  • Obtain society fit-out guidelines, security deposit receipt, and noise curfew timings

Stage 2: Scope Engineering, Itemised BOQ Costing and Quotations

Once dimensions are verified, the next critical step is translating design intent into an accurate Bill of Quantities (BOQ). Many studios send clients lump-sum quotes such as "Master Bedroom Wardrobe with Loft: โ‚น2,10,000". Lump-sum pricing almost always leads to disputes because neither the carcass core, the laminate brand, nor the hardware tier is documented.

As detailed in our guide to interior BOQ formatting, an itemised BOQ breaks every line into four explicit elements: the base carcass board, the external and internal surface finishes, the hardware specification, and the labour allowance.

AttributeTraditional lump-sum quoteItemised BOQ system
Core materialCommercial ply / good quality board18mm BWP Marine Plywood (IS 710 certified, calibrated) for wet zones; 18mm HDHMR for dry wardrobes.
Surface finishLaminate finish as per selectionExternal: 1.0mm matte/suede laminate (Merino/Greenlam) with matching 2mm PVC edge banding; Internal: 0.8mm off-white liner laminate.
HardwareStandard soft-close fittingsHettich Sensys / Hafele Metalla 110ยฐ soft-close hinges (3 per shutter) with concealed telescopic soft-close drawer runners.
Tax treatmentTaxes extra as applicableItemised 18% GST under SAC 9954 (works contract service) shown clearly on quotation totals.

A dependable BOQ system also maintains two distinct rate tiers: the internal cost rate (what your studio pays for materials and subcontracted labour) and the client selling rate (incorporating your studio markup and contingency buffer). Separating these rates ensures your team tracks profitability in real time without exposing internal cost margins to clients.


Stage 3: Drawing Revision Control and Trade Execution Sequencing

A common on-site error in Indian fit-outs occurs when carpenters build to an earlier drawing revision while the designer and client agreed to a revised layout on a phone call. Preventing outdated drawings on site requires a disciplined revision control protocol.

Keep all 2D working drawings (civil demolition, masonry, electrical conduit layouts, plumbing schematics, false ceiling framing, and modular fabrication details) in a centralized project repository. Once a client approves a drawing set, freeze it as baseline Revision 0. Any subsequent adjustment must be logged as Revision 1 with a dated change stamp, highlighting the affected area.

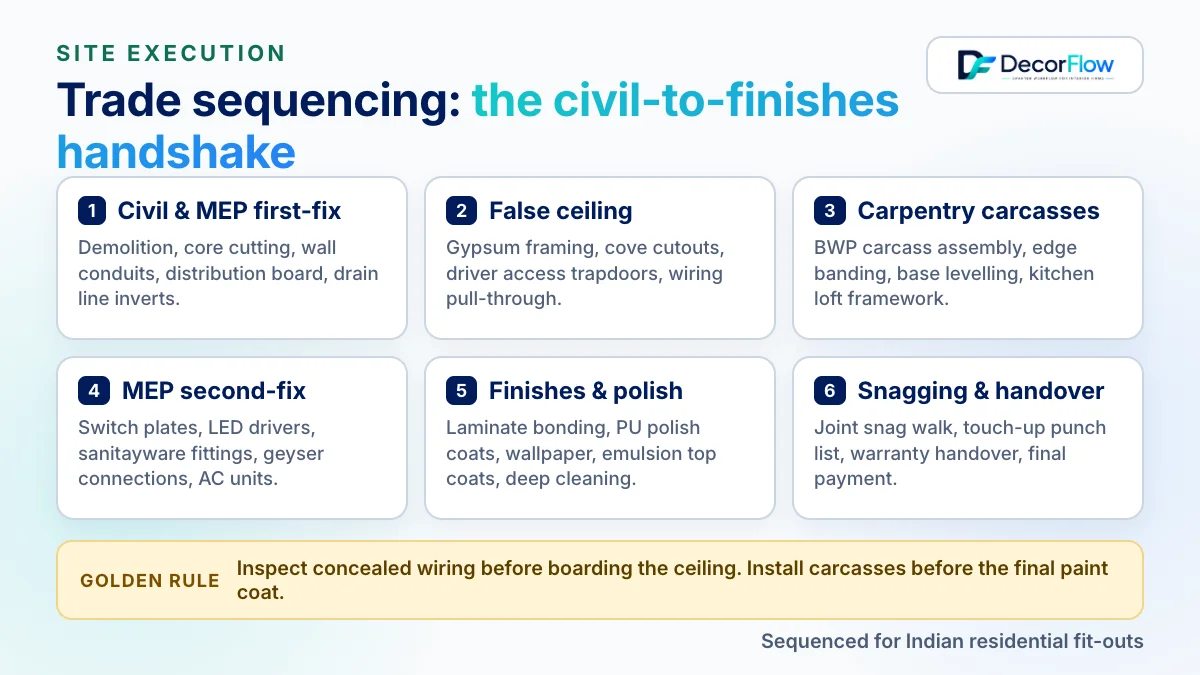

Diagram showing the 6-stage trade execution sequence for Indian interior projects
The trade execution handshake: sequencing civil, MEP, false ceiling, carpentry, and finishing works to prevent trade collisions.

Executing an apartment fit-out without trade clashes requires coordinating sub-contractors in a strict sequence:

  1. Stage 1: Civil demolition and structural prep: dismantle existing partitions, complete core cutting for kitchen chimneys and AC copper pipes, and clear malba from the site.

  2. Stage 2: First-fix MEP (Mechanical, Electrical, Plumbing): chase walls for electrical conduits, run switchboard boxes, lay internal plumbing pipelines, and test drain slopes.

  3. Stage 3: False ceiling framing and electrical pull-through: install perimeter GI channels, hang ceiling grids, pull electrical wiring to light cutouts, and install LED driver inspection trapdoors.

  4. Stage 4: Carpentry carcass assembly and modular installation: assemble wardrobe and kitchen carcasses on level base plinths, edge-band all exposed plywood edges, and secure carcasses to walls.

  5. Stage 5: Second-fix MEP and surface finishes: fit switch plates, install sanitaryware and CP fittings, hang modular shutters, and apply primer and putty coats.

  6. Stage 6: Final paint coats, PU polish, and deep cleaning: spray final coats of PU or melamine on wood, apply final emulsion paint coats, clean window tracks and tiles, and conduct a joint snagging walk.

In DecorFlow Project Management, drawing sets, progress updates, and trade checklists remain linked to the project record, allowing site supervisors and principals to view current drawing versions on mobile.


Stage 4: Procurement Discipline and 3-Way Vendor Matching

Procurement is where working capital leaks fastest when unmonitored. Sending casual WhatsApp messages to local timber and hardware merchants ('Send 25 sheets of 18mm ply to Flat 402') creates billing discrepancies and delivery shortages.

To keep material budgets on track and protect your firm's cash flow, establish a disciplined 3-way matching protocol:

  1. Material take-off and Purchase Order (PO): release material requirements directly from the approved BOQ. Issue a formal PO stating the exact brand, grade, thickness, agreed trade rate, delivery address, and expected date.

  2. Physical delivery verification (Goods Receipt Note / GRN): when the delivery truck arrives, the site supervisor inspects sheet counts, checks laminate sheet codes against the PO, and inspects hardware boxes before signing the challan.

  3. Vendor tax invoice reconciliation (3-Way Match): before releasing vendor payments, accounts reconciles the vendor's tax invoice against the original PO and the signed site GRN. Only verified quantities at agreed rates are approved.

BOQ Material Indent โ”€โ”€โ”€โ”€โ–บ Purchase Order (PO) โ”€โ”€โ”€โ”€โ–บ Physical Delivery (GRN) โ”€โ”€โ”€โ”€โ–บ Vendor Tax Invoice
          โ–ฒ                                                      โ–ฒ                       โ–ฒ
          โ””โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€ Reconciled via 3-Way Match โ”€โ”€โ”ดโ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”€โ”˜
                                    Payment approved only for verified goods

Learn more about connecting material indents and delivery checks with DecorFlow Procurement & GRN and Vendor Management.


Stage 5: Client Communication, Change Orders and Recorded Handover

Homeowners do not call multiple times a day because they want to disrupt work. They call because silence and messy demolition work create anxiety. Managing client expectations with structured updates is as vital as managing carpentry on site.

Move approvals out of WhatsApp into a dedicated portal

When clients, designers, and site supervisors share a single chaotic WhatsApp group, design reviews get buried, drawing links expire, and verbal agreements turn into disputes. Transitioning clients to an organized portal provides several advantages:

  • Passwordless phone OTP access: homeowners sign in using their mobile number without needing complex passwords.

  • Curated progress updates: share photo carousels of completed work while keeping internal trade notes and cost records private.

  • Auditable design and proposal approvals: clients review room boards, approve proposals, or submit revision notes with timestamped records.

  • Milestone payments and invoice tracking: stage client disbursements to verifiable physical deliverables rather than arbitrary calendar dates (see our guide on interior design payment terms).

The rupees-and-days change order rule

Scope changes are normal in interior projects, but unbilled scope changes erode margins. Enforce a strict policy: no variation work begins on site without an approved change order that specifies two non-negotiable variables:

  1. Net financial adjustment (โ‚น): extra material costs, subcontracted labour, markup, and 18% GST.

  2. Timeline impact (working days): the exact number of days added to the contractual handover date.

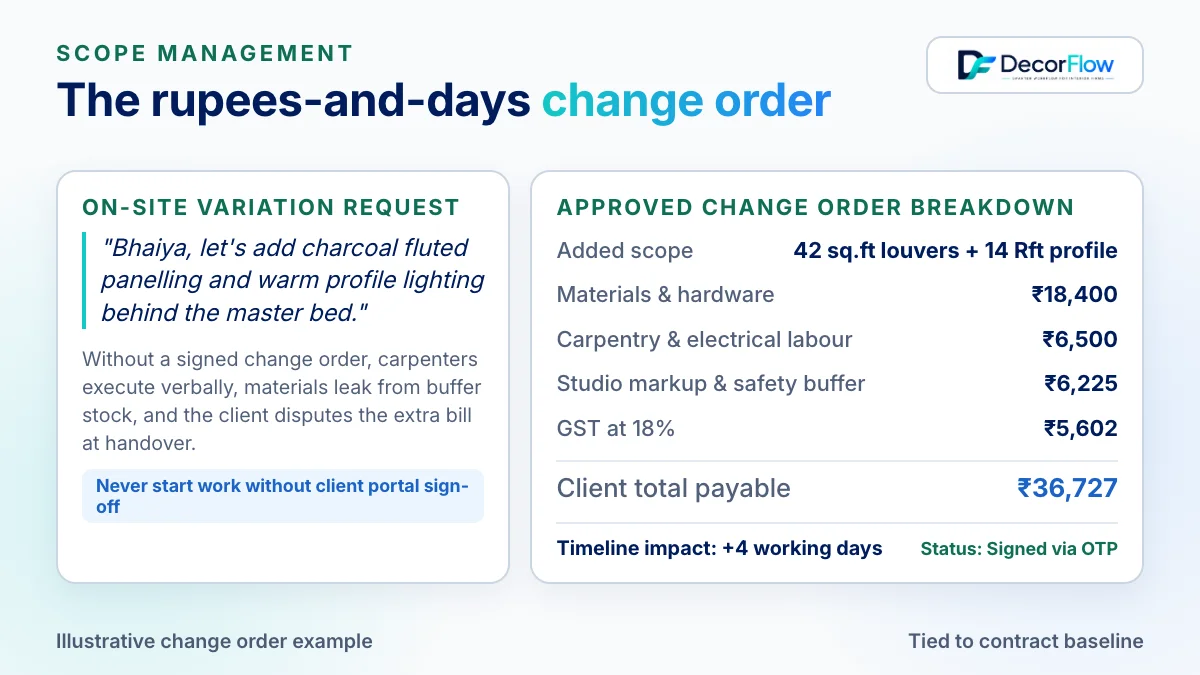

Diagram showing the anatomy of a rupees-and-days change order for interior design
A formal change order prices scope additions in rupees and working days before materials are ordered or work begins on site.

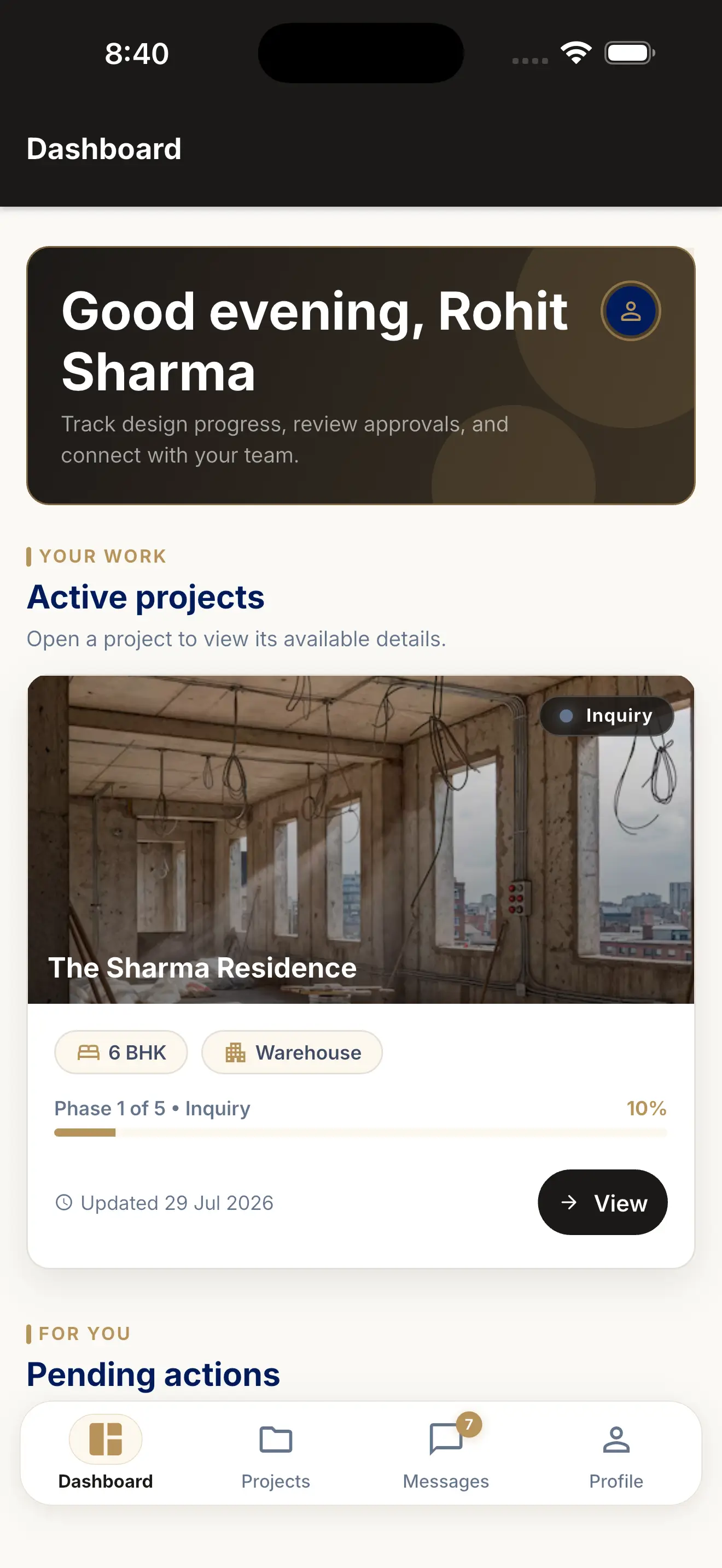

DecorFlow client portal showing drawings, project timeline and payment milestones for a homeowner
The DecorFlow Client Portal gives homeowners a curated view of approved designs, site photos, and payment milestones.

Explore how to give clients an organized experience with the DecorFlow Client Portal.


Operational Checklist for Every Interior Project

Use this 10-point checklist as an operational baseline across every residential or turnkey fit-out your studio manages:

  • Complete a digital site survey capturing floor-to-soffit heights, beam bottom levels, and DB capacity
  • Verify apartment society lift dimensions, security deposit terms, and permitted working hours
  • Publish an itemised BOQ detailing core board, laminate thickness, and hardware brand
  • Maintain internal cost rates separate from client selling rates with defined contingency buffers
  • Freeze approved drawings as baseline Revision 0; stamp and date all subsequent layout revisions
  • Inspect electrical conduits and plumbing lines before false ceiling boards are installed
  • Issue formal purchase orders tied to BOQ material requirements before ordering from vendors
  • Log mobile Goods Receipt Notes (GRNs) on delivery challans to verify sheet counts and hardware condition
  • Reconcile purchase orders, delivery GRNs, and vendor tax invoices before releasing payments
  • Conduct a joint snagging inspection with the client and document rectified punch list items before final handover

Frequently Asked Questions About Interior Project Management

Frequently Asked Questions


Summary and Next Steps

Scaling a profitable interior design firm in India requires transitioning from informal firefighting to a connected operational system. When site survey measurements flow directly into itemised BOQs, drawings remain version-controlled, material deliveries are verified before payment, and client approvals are documented in a dedicated portal, projects finish on schedule and protect their margins.
