How to Avoid Delays in Interior Design Projects: A Practical Guide for Indian Firms

Most interior project delays start with late decisions, changing scope, unready sites and short deliveries. Here is how Indian firms can plan around each.

DecorFlow Editorial Team··11 min read
Summarise with AI:
Timeline of a ten-week interior project marking the eight handoffs where days are usually lost, from scope approval to handover

Ask a studio owner why a 3 BHK job slipped by three weeks and you will hear about carpenters, painters or the monsoon. Open the project file afterwards and the cause is often earlier: a finish chosen late, a drawing revised after cutting began, a flat that was not really ready on day one, or a delivery that came short and nobody noticed for four days.

This guide covers the handful of handoffs where interior projects lose days, and what a studio can put in place for each one: a scope freeze, a decision calendar, materials planned as a schedule, a written trade sequence, changes priced in rupees and days, and a weekly update. It is written for studio owners, project managers and site supervisors running residential and small commercial jobs in India.

Where interior projects actually lose days

Delays rarely have a single cause. The table lists eight handoffs where schedules commonly slip, the warning sign that usually shows up first, and the fix. Many of these warning signs show up before the date actually moves.

Where days are lostEarly warning signWhat to put in place
Scope changes after approval"Can we just add..." after drawings are signedFreeze scope; every change becomes a priced, dated variation
Slow client decisionsSelections still pending after the agreed date; the same question asked three timesA decision calendar with dates, sent in writing
Site not readyPrevious trade still working; society permission or lift booking pending; point positions unmarkedA site-readiness check before the start date
Long-lead items ordered lateOrders placed after civil work has begunOrder from the approved BOQ and write the vendor's lead time on the PO
Short or wrong deliveriesMaterial arrives but quantity or finish does not match the orderReceive against the PO on the day and record shortfalls
Trades collidingPainter and carpenter in the same room; electrician waiting for ceiling framingA written trade sequence with one owner per room per day
Payment-linked slowdownsWork slows when a stage payment is pendingTie payment stages to visible milestones and invoice on completion
Bad news arriving lateThe client hears about the slip in handover weekA weekly update; every delay reported with a revised date

Freeze scope before the first wall is touched

A schedule is only as stable as the scope behind it. Before execution starts, get the following in writing and make sure the whole team is working from the same revision.

  • Quotation approved by the client, with the version number recorded
  • Working drawings issued with revision numbers, and older printouts withdrawn from site
  • Electrical, plumbing and AC point positions confirmed on the drawing and marked on site
  • Finish, laminate, hardware and fixture selections signed off
  • Site measurements checked against the drawings before any factory cutting
  • Society permissions, working hours, lift booking and debris rules confirmed
  • One named person on the client side who gives decisions

Measurements sit underneath all of this. Capturing rooms on site once and carrying them into costing removes one common source of rework; a site survey workflow is built for exactly that.

Build a decision calendar with the client

Client decisions are among the most controllable causes of delay, because the studio knows in advance which decision blocks which trade. Work backwards: for each trade, list what must be decided before it starts, then give the client a date for each in writing at the start of the job.

The table below is an illustrative calendar for a 3 BHK turnkey flat planned over about ten weeks, where week 0 is the day the site is handed over to the execution team. Your durations will differ; build yours from your last few completed jobs.

DecisionLock byWhat it blocks
Electrical and plumbing point positionsWeek 0Chasing, concealed wiring and pipework
False ceiling and lighting layoutWeek 1Ceiling framing and electrical rough-in
Carpentry and wardrobe drawings (with revision number)Week 1Factory cutting and site carpentry
Laminate, veneer and hardware: brand, finish, quantityWeek 1Purchase orders for the longest-lead items
Paint shades and wall finishesWeek 5Putty and painting
Curtains, loose furniture and decorWeek 6Final installation and handover

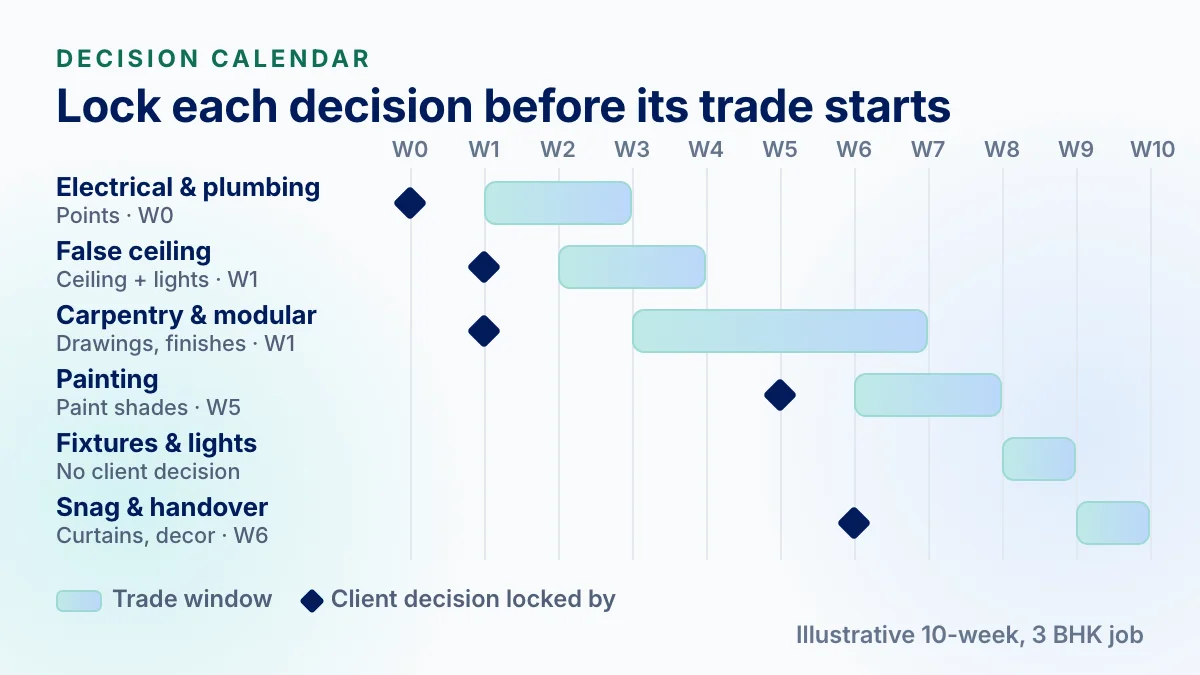

Illustrative ten-week chart placing client decision deadlines before the trades they block, from electrical and plumbing points in week 0 to curtains and decor in week 6
Illustrative decision calendar for a ten-week, 3 BHK turnkey job. Dates are examples, not a standard.

Put the consequence in the same message as the date: "If paint shades are not final by week 5, painting starts a week late and handover moves by a week." Send a reminder two days before each date and keep the reply on record.

Plan materials as a schedule, not a shopping list

Materials often delay a job not because the vendor is slow, but because the order went in after the work that needed it. Treat procurement as part of the schedule.

  1. Turn the approved BOQ into a requirement list grouped by trade, with the date each item is needed on site.

  2. Ask every vendor for a lead time in writing and put it on the purchase order.

  3. Order the longest-lead items first: special laminates and veneers, specific hardware, stone, fabric and custom fixtures.

  4. Receive against the PO on delivery: count, finish and damage, with photos. Record a shortfall the same day.

  5. Give the supervisor a short "arriving this week" list so nothing surprises the site.

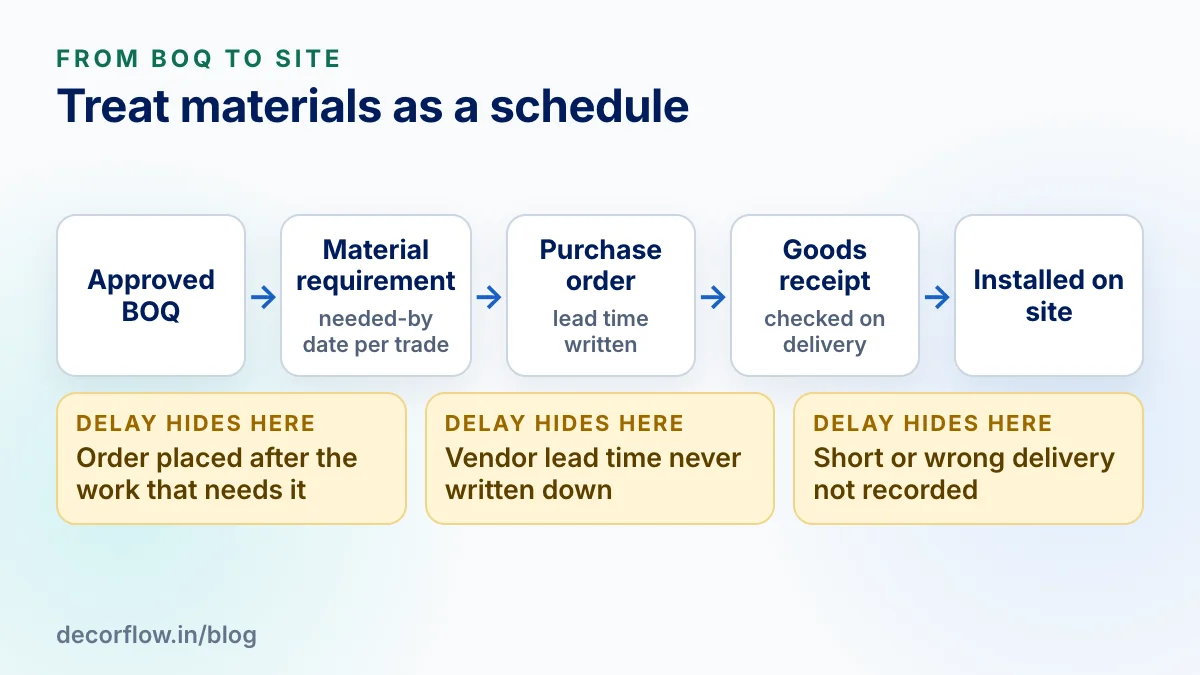

Flow from approved BOQ to material requirement, purchase order, goods receipt and installation, with three points marked where delays commonly hide: late ordering, unrecorded lead time and unchecked receipts
Where delays hide between the approved BOQ and installation.

In DecorFlow procurement, material requirements are generated from the approved BOQ, purchase orders can be raised and revised, and goods receipt notes are recorded against each order, so a PO shows as not received, partly received or fully received. A short delivery becomes visible on the day it arrives instead of in the middle of the carpentry stage.

Write the trade sequence down

Trades collide when the order lives in the supervisor's head. Write the sequence, share it with every contractor and give each room one owner per day. A typical order for a residential flat looks like this, though wet areas and tiling will change it:

  1. Civil alterations and waterproofing

  2. Electrical and plumbing rough-in

  3. False ceiling framing and services

  4. Carpentry and modular installation

  5. Putty and painting

  6. Fixtures, lights and switch plates

  7. Deep clean, snag list and handover

The sequence is also where you check readiness. Before a trade starts, confirm the previous one is signed off, the room is clear, and the materials for the new trade are on site.

Price every change in rupees and in days

Most studios price a change in rupees. Few state what it does to the date, and that is what the client forgets. For every change after approval, write down what is added or removed, the rupee impact, the days it adds or saves, and get the client's confirmation before the work begins.

An illustrative example: after drawings are approved, the client asks for a pooja unit in the living room. The variation reads "add pooja unit, +₹68,000, +4 working days, new handover date confirmed in writing." Once it is written like that, the client can choose to proceed, trim the scope or accept the new date.

DecorFlow's quotation change orders record a variation against the approved quotation (add, modify, remove, or a site-condition change) and calculate the net change and the timeline impact in days, then sync the change back to the BOQ.

Tell the client early, with a new date

Clients usually take a delay better than a surprise. A habit that helps is a short weekly update that always contains the same four things: what finished against plan, what is pending from the client and by when, any change to the handover date, and photos from site.

With project management in DecorFlow, the studio keeps milestones with planned and completed dates and posts progress updates with photos. Clients see those updates in the client portal, where they can also approve designs and quotations or send them back with revision notes, so approvals leave a record instead of living in a chat thread.

A weekly delay review

Once a week, with the project manager and supervisor, go through these questions. Keep it short; it works best when the answers are already on paper.

  • Which milestones were due this week, and which are finished?
  • Which client decisions fall due in the next two weeks?
  • Which materials are due on site this week, and was anything received short?
  • Which trade starts next week, and is the room ready for it?
  • Which changes were requested, and are they priced in rupees and days?
  • Has the handover date moved, and has the client been told?
